Flexible demand access permits: what do they mean for your projects?

Since 1 September 2026 there is an alternative to refusal when the grid has no capacity: the flexible access permit. We break down the CNMC resolution, its four permit types and how they change the valuation of storage projects.

Flexible demand access permits have been a reality since 1 September. But assessing their implications is still a challenge.

If, over the last 12–24 months, you have tried to originate a storage project, connect an industrial electric boiler or develop a data centre, the constraint you most likely ran into was the grid:

"No capacity available."

The first demand capacity maps showed 83.4% of distribution nodes (>1 kV) with no available capacity, and Red Eléctrica found headroom for new demand at only 25% of transmission nodes.

On 1 September 2026, however, an alternative to refusal was created: the flexible access permit, regulated by the CNMC Resolution of 31 July 2026 (BOE-A-2026-17571).

Connecting, yes. But without a guarantee of supply in every hour of the year.

The resolution turns flexibility into a condition of grid access. For storage, it is also an obligation with a deadline.

The technical design is tiered and detailed, but risk allocation is asymmetric. The permit holder accepts restrictions without prior notice in some types, without compensation, without any discount on network tolls and with no defined path towards firm capacity. Meanwhile, the rules that would make it possible to bound that risk are still being drafted.

Until those rules arrive, the recommendation is not to assume, but to model: the zone's pattern, the elements identified in the preliminary proposal, the type chosen and the asset configuration all change how assets are valued.

This article takes the regulation apart piece by piece: where it comes from, how each permit type works, what it requires of the permit holder, how it affects batteries, hybrids and industrial consumers, and which questions remain unanswered.

Starting point and need

Once grid operators began publishing demand access capacity more transparently, an urgent problem became clear: most nodes appeared as congested. This blocks the origination of new projects and slows the arrival of new industry and storage.

At the same time, the data on actual grid utilisation (still not very transparent) showed that the distribution grid was in fact being used well below its nominal capacity.

On top of that, two main catalysts forced a rapid search for solutions to this problem:

Let's look at this context and need in a little more detail.

Why is there, in fact, spare grid capacity almost all year round?

A firm permit requires the grid to meet security criteria both with all its elements available and with one of them out of service (N-1). Sizing the grid for this "worst possible case" leaves capacity idle most of the time.

To give a concrete, easy-to-understand example:

Imagine a household consumer on a 2.0 TD tariff with a peak power of 7 kW. That consumer is "reserving" 7 kW of distribution grid capacity. This means the grid allows them to consume up to 7 kW all year round, at any time (even if a nearby transformer fails).

All of this with a guarantee of supply. Because the grid does not know, and should not need to know, when that consumer might want to take a hot shower, charge their electric vehicle and put a cake in the oven at the same time.

In reality, however, that consumer, like everyone else, practically never reaches or exceeds the 7 kW of contracted peak power. Their average consumption is more like 1–2 kW.

Physical saturation and administrative saturation

Not all constraints are technical. After publishing its demand capacity listings, Redeia argued that the transmission grid cannot be considered collapsed, since capacity has been granted to a very significant number of consumers. In fact, demand pending connection to the transmission grid alone could represent a 25% increase on the country's current electricity demand.

Grid saturation is therefore the sum of technical constraints and the problem of permit hoarding, which Redeia and the Ministry have spoken about openly.

That is why RDL 7/2026 introduced interim milestones for demand permits that have not yet signed an access contract, in the hope of forcing "speculators" who hoard access rights without a real project to give up their permits: payment of 10% of the grid position at 12 months, commissioning of the project design at 3 years and a technical access contract at 4 years. It also introduced a capacity reservation charge for demand connected at 1 kV or above.

Flexible access is the third lever: it does not free up idle permits, but it makes better use of the grid that already exists.

Regulatory framework and timeline

Flexible permits are rooted in Directive (EU) 2019/944 on common rules for the internal market for electricity. Specifically, in Article 6a, which requires flexible connections to be offered in congested areas, and which was introduced by Directive (EU) 2024/1711 on the reform of electricity market design.

Competence within the Spanish regulatory framework comes from Article 33.11 of Law 24/2013 on the Electricity Sector, which tasks the CNMC with approving, by circular, the methodology and conditions for access and connection.

The key piece is Circular 1/2024 of 27 September (BOE of 11 October 2024) on access and connection of demand facilities. Three of its articles underpin everything that follows:

Two earlier specifications build on this framework: the Resolution of 8 June 2025 (firm demand capacity in distribution, BOE of 18 June) and the Resolution of 1 December 2025 (demand capacity in transmission, BOE of 10 December), which already treats storage access to the transmission grid as flexible.

The July 2026 resolution (case RDC/DE/003/25) completes the puzzle for flexible capacity.

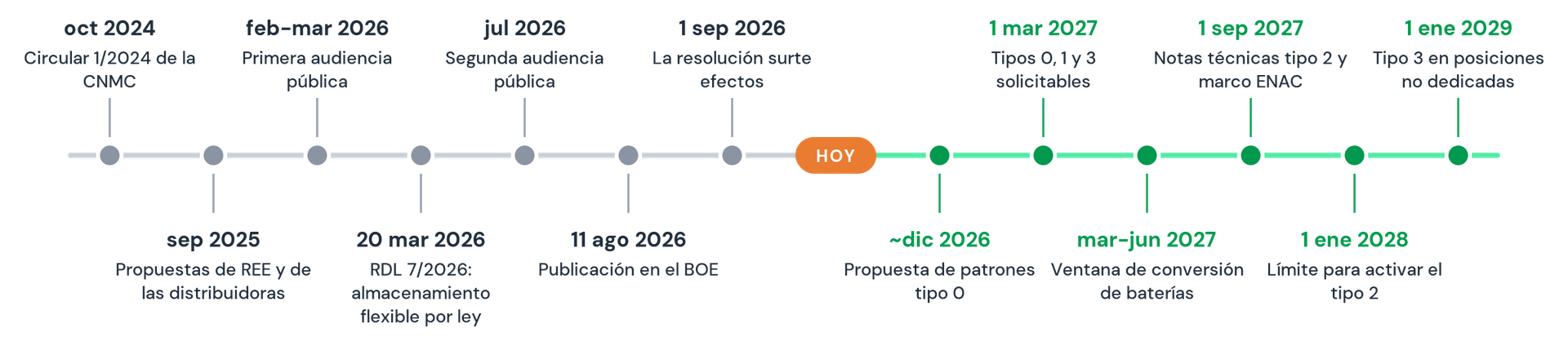

Timeline of the regulatory framework for flexible access

How does flexible access work?

Before going into each type, these are the common rules set out in the first operative provision of the resolution:

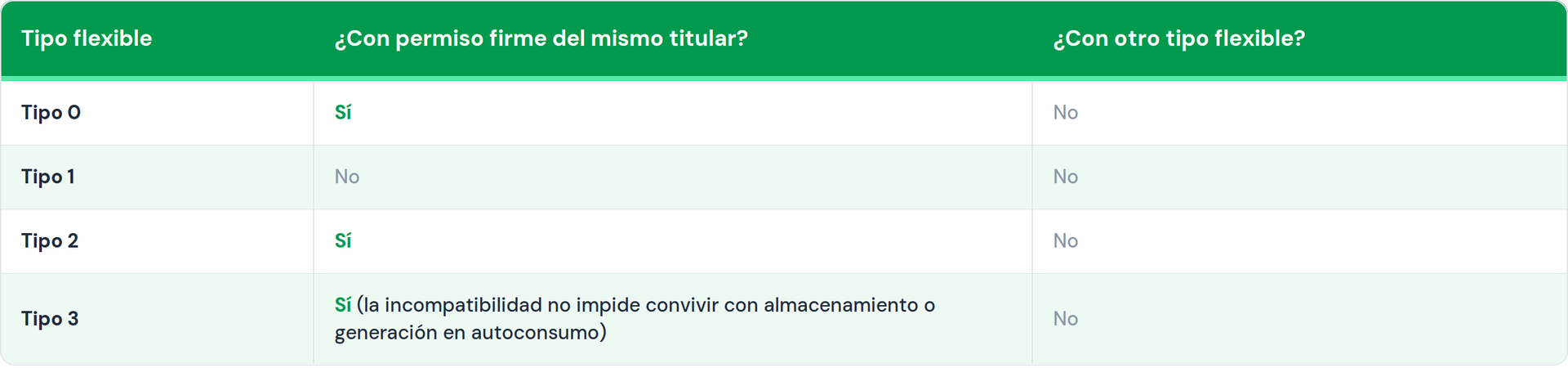

Which types of demand permits can coexist at the same connection point?

Which demand permit types can coexist at the same connection point

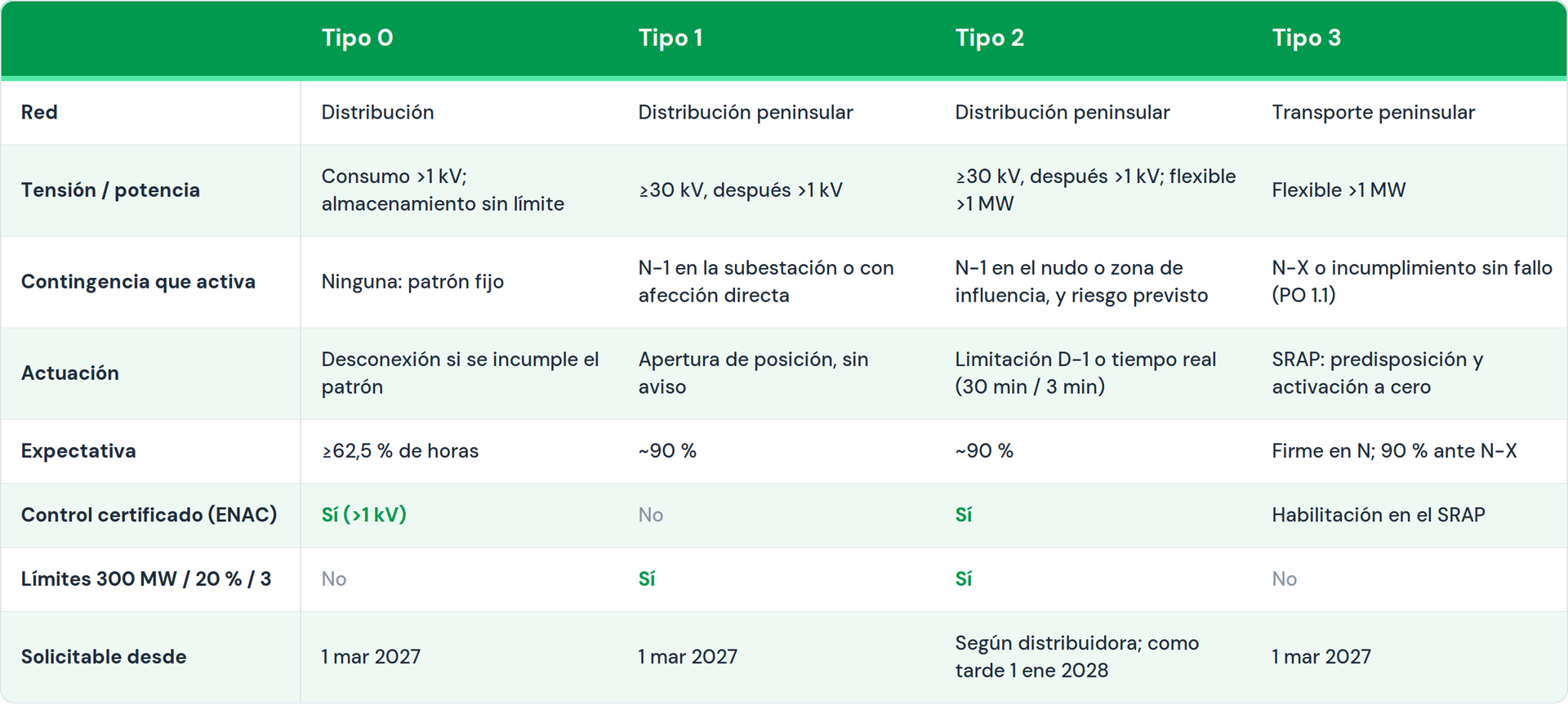

The 4 types of flexible permits

In this section, we assume readers already know the characteristics of each type of flexible permit. We give only a very brief description, and then focus on the most relevant particularities of each permit type.

The 4 types of flexible access permits

Type 0: limitations by time pattern

The most relevant particularities of Type 0 permits are:

Still pending:

Type 1: remote disconnection in case of unavailability

The most relevant conditions of Type 1 permits are:

Still pending:

Type 2: dynamic limitation by instructions

Still pending:

Type 3: automatic reduction in transmission

Still pending: the reactive power requirements to be proposed by REE.

POD1 and the operational plumbing

The CNMC resolution approved the first Distribution Operating Procedure (POD1), the manual that allows distribution companies to operate flexibility in real time. It is the least eye-catching piece, but without it the Type 1 and Type 2 instructions would have no operational basis.

This POD lays the foundations for observability and controllability of flexible assets by distribution system operators.

Assessment and impact on projects

What should storage developers do?

RDL 7/2026 amended the Electricity Sector Law so that access and connection permits for storage are considered flexible from the demand perspective, and its sixth transitional provision requires permits already granted to be adapted. The resolution sets out how in its fifth operative provision.

Distribution projects not in operation as of 1 September 2026:

  1. Once Types 0 and 1 are activated (1 March 2027), they have 3 months to request conversion of their demand permit to Type 0 or Type 1, with processing priority over new applications.
  2. If they do not adapt, they lose the exemptions under Article 1.3.b of RD 148/2021 (charges) and Articles 2.2.c and 2.2.d of Circular 3/2020 (network tolls), and become liable for the capacity reservation charge under Article 11 of RDL 7/2026.
  3. When the distribution company activates Type 2, they have a further 3 months, also with priority, to move from Type 0 or 1 to Type 2.

Distribution projects already in operation:

  1. They are considered flexible unless the permit holder expressly states otherwise, and they continue operating under the same conditions as before until flexible permits are effectively implemented.
  2. If they meet Type 2 requirements, they have 3 months from its activation to request conversion, with priority.
  3. If they do not adapt, they lose the same exemptions on network tolls and charges.

Common conditions for projects with access and connection permits already granted

The update requires a capacity study and evidence of compliance with technical, safety and control requirements, and it is processed as a modification of the permit, not as a new application. The Type 1 and Type 2 limits of 300 MW, 20% and 3 facilities do not apply to these batteries.

Transmission projects

All storage permits in transmission are considered flexible without conversion, and the conditions of those already in operation are not changed by this resolution.

How do flexible permits affect projects?

Economic impact

There is a common factor that is easy to understand for any type of flexible permit: moving from firm to flexible permits means lower merchant revenues.

The question is: how much does it affect each project?

And it is a hard one to answer, because:

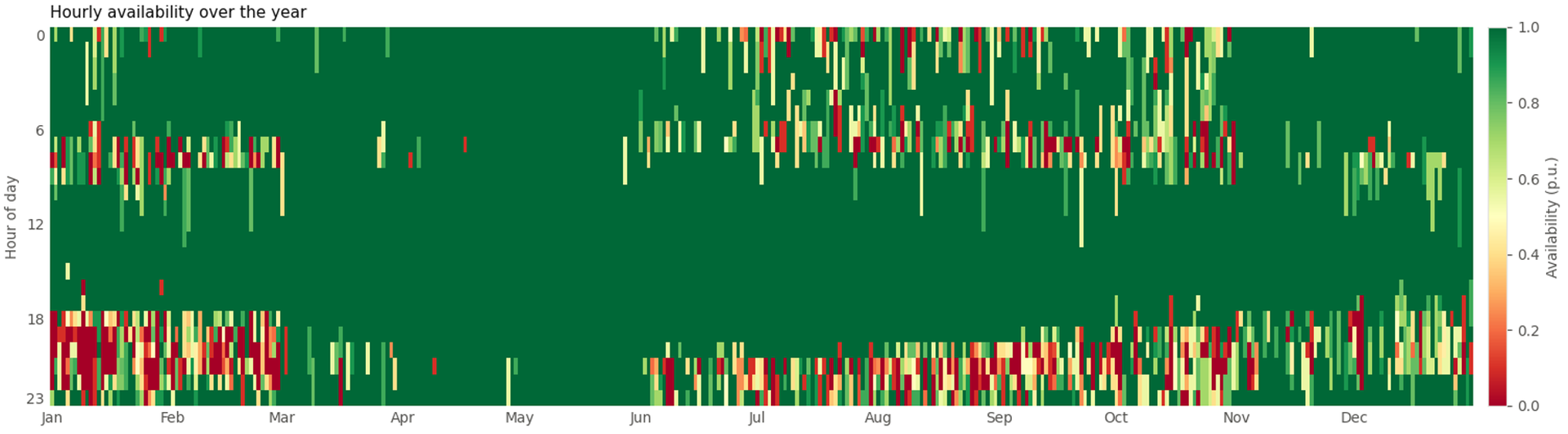

Example Type 2 flexible permit profile

Example of a Type 2 profile with unavailability or limitations for 10% of equivalent hours. Profile generated for simulations on our SaaS platform One Hub Analytics for a specific node of the distribution grid.

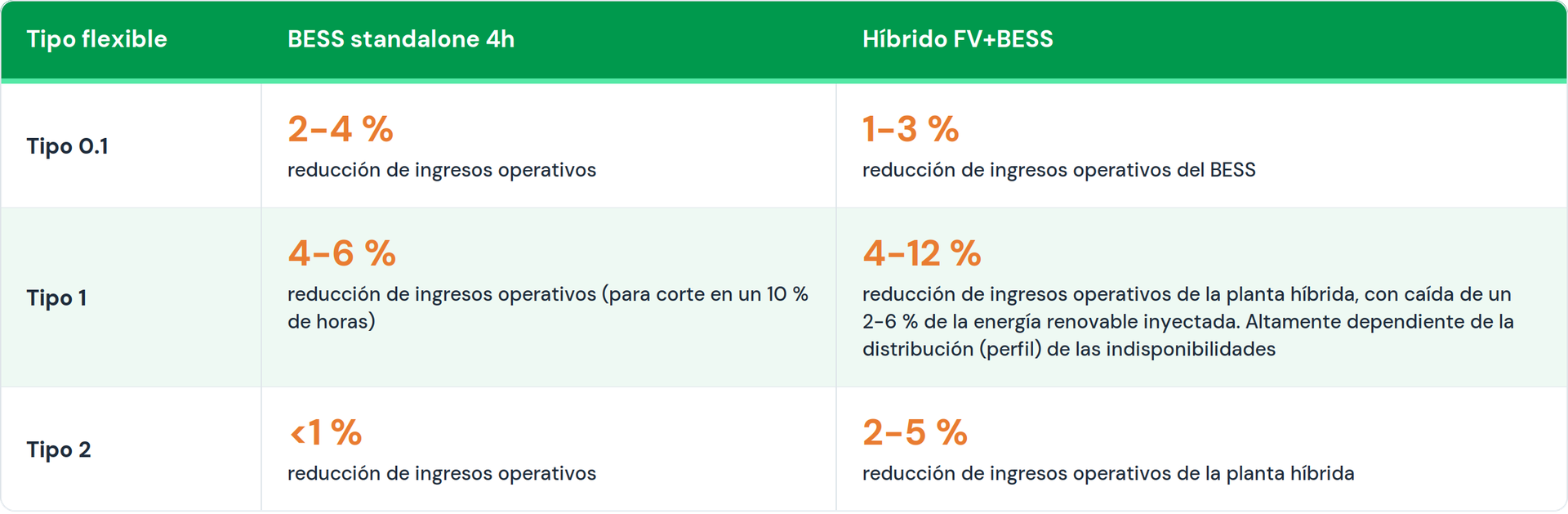

Revenue impact by flexible permit type

Would you like to understand how flexible permits affect your project, and support its valuation in M&A or financing processes? Contact us.

Conclusions and open issues

What do flexible permits solve, and what do they not solve?

✓ What they solve:

✕ What they do not solve:

The CNMC also points to regulations outside its competence that will need to be amended (RD 1048/2013, RD 1183/2020, the contracting regime and RD 1110/2007), and suggests a comprehensive regulation on storage.

Some open questions on flexible permits

On priority and existing permits:

On capacity, maps and tenders:

On transparency and signals:

On operation and markets:

On economic criteria:

Do you have questions about the regulation and/or how to get your storage project permitted? Contact us
